Description

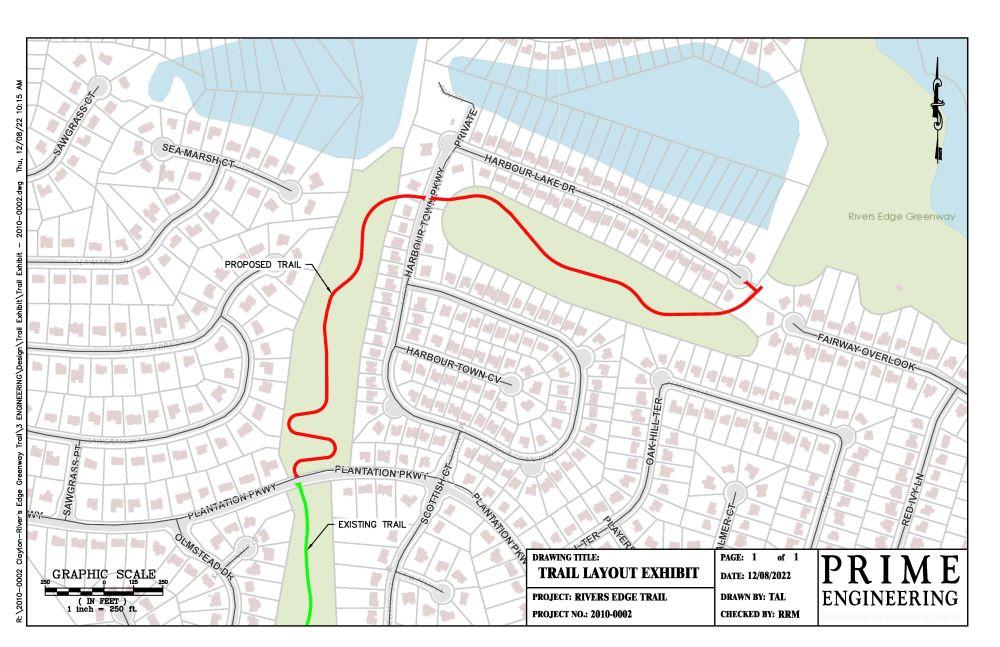

This project consist of constructing an asphalt ADA accessible walking trail from Plantation Parkway crossing over Harbour Town Parkway continuing to Harbour Lake Drive cul-de-sac through 16.32 acres.

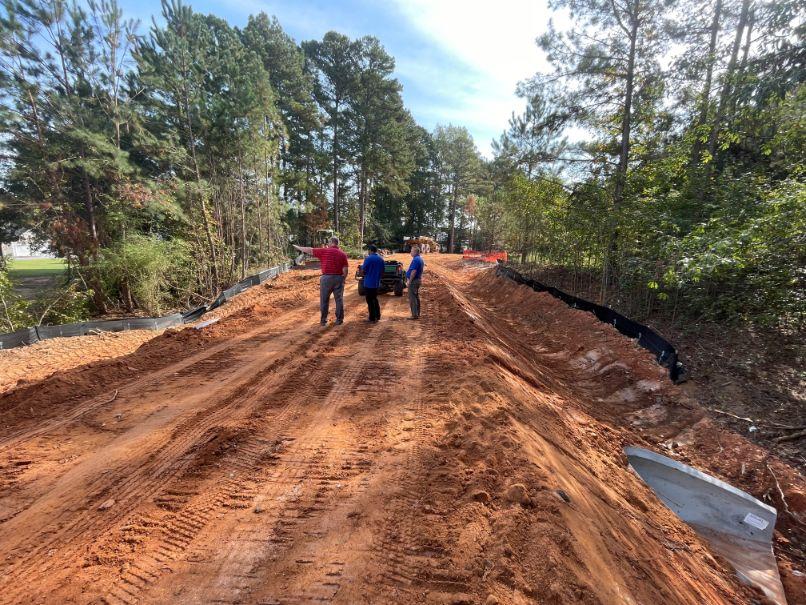

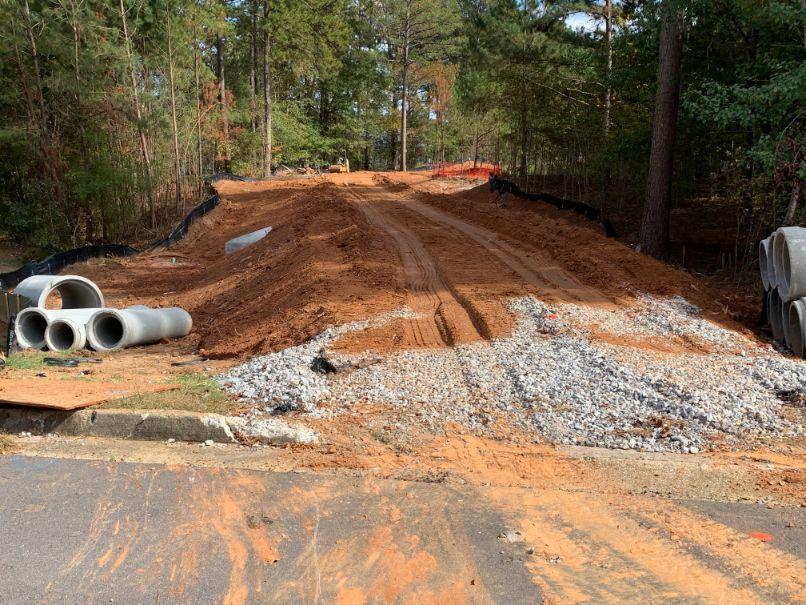

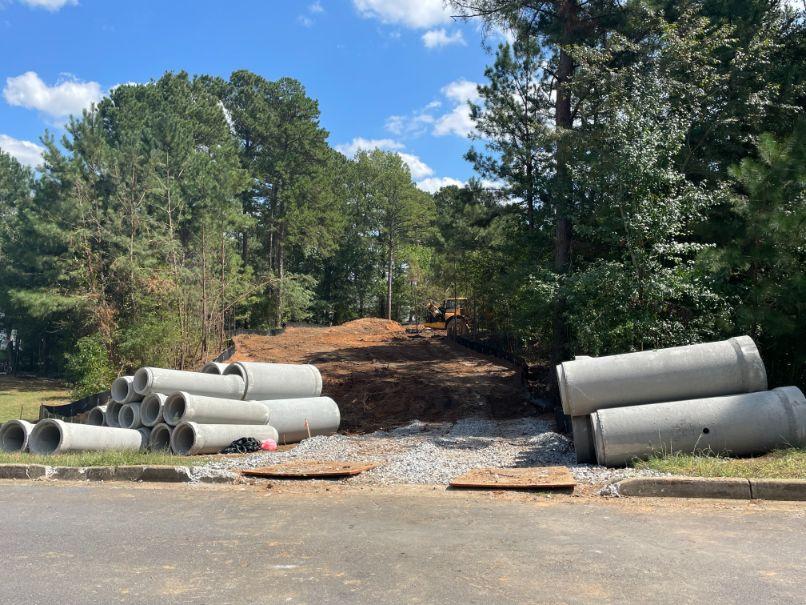

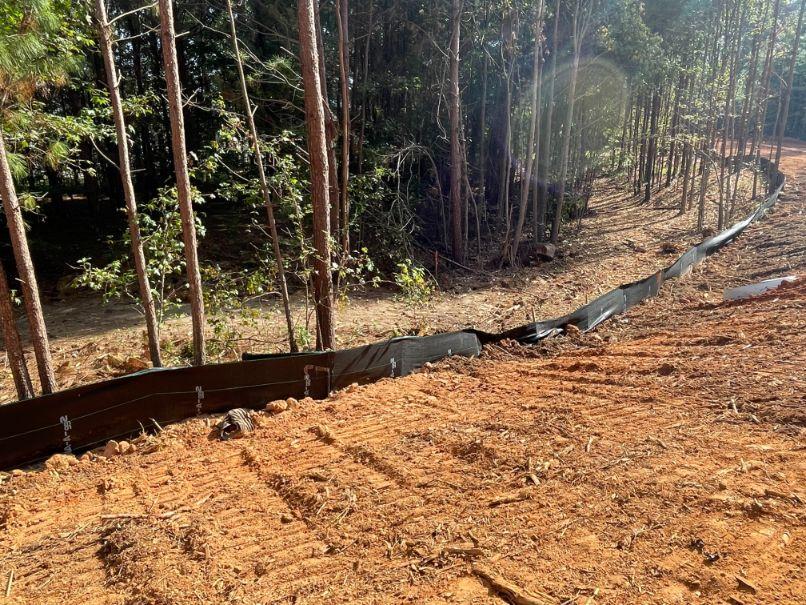

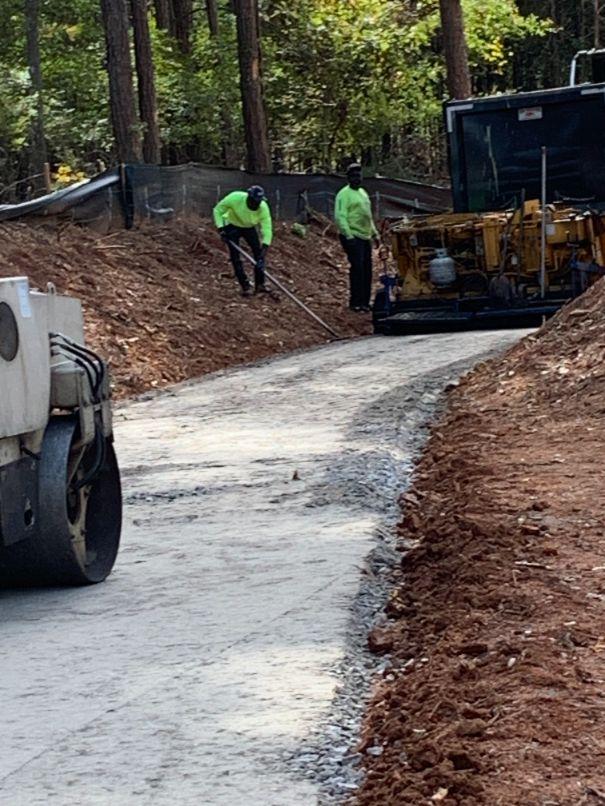

October 2023: Paving of the new walking trail has started with a completion date set in late November.

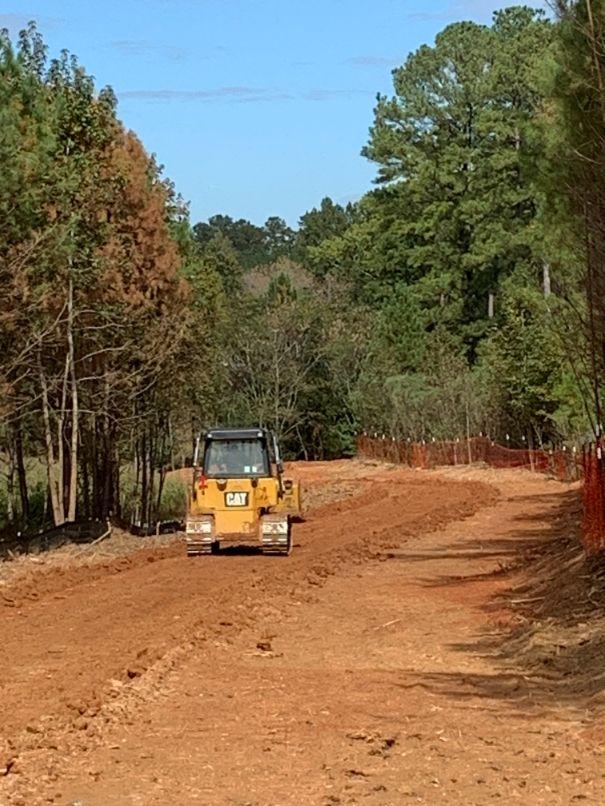

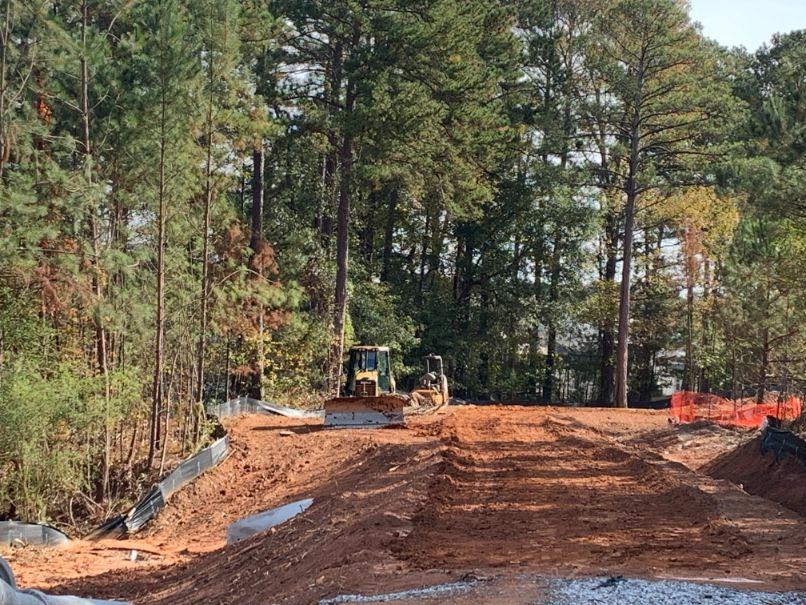

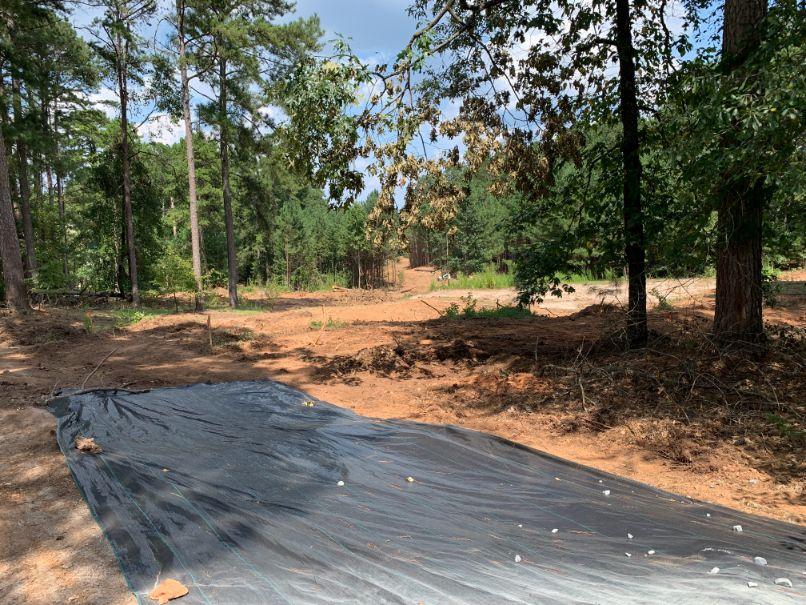

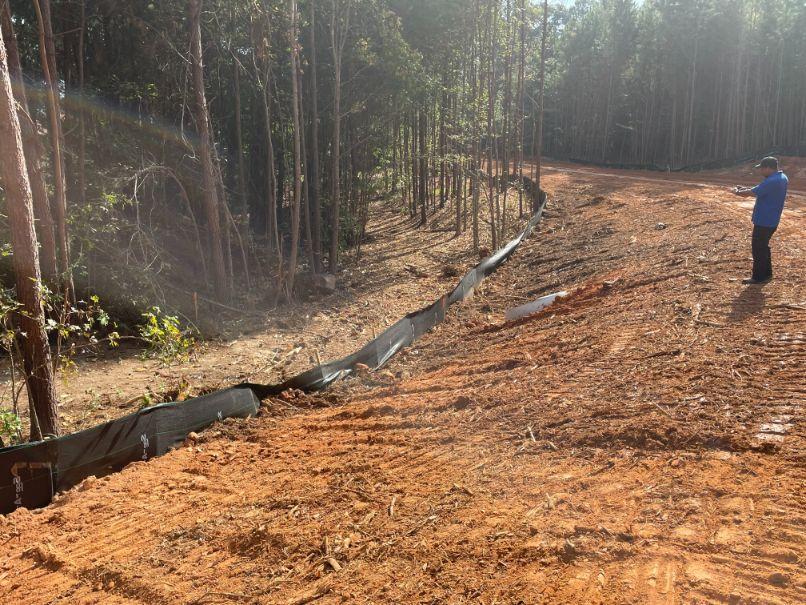

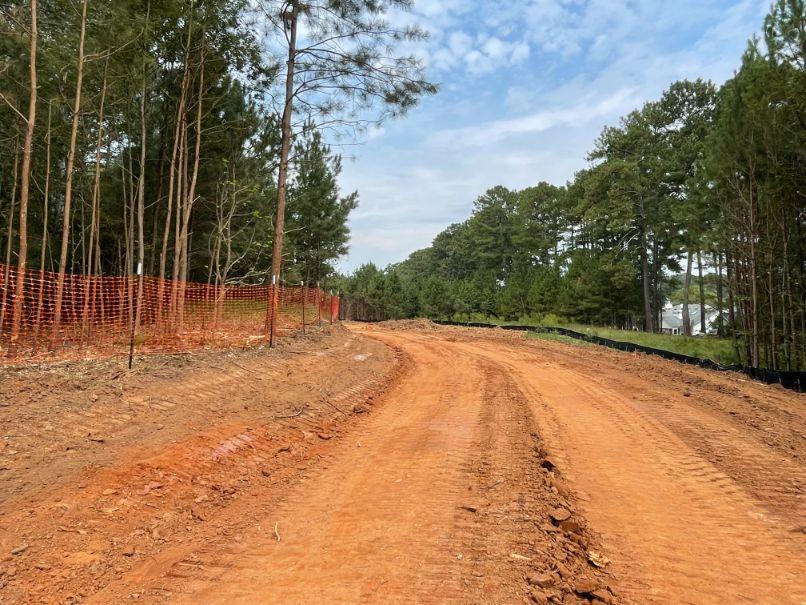

September 2023: Prime Engineering is clearing and leveling the trail in preparation for laying asphalt. The next step will be to determine the placement of the paved trail within the clearing.

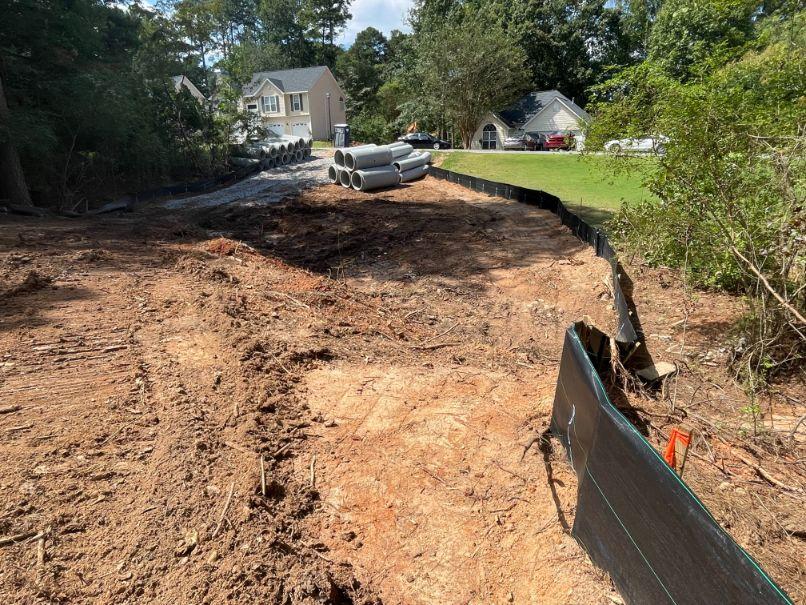

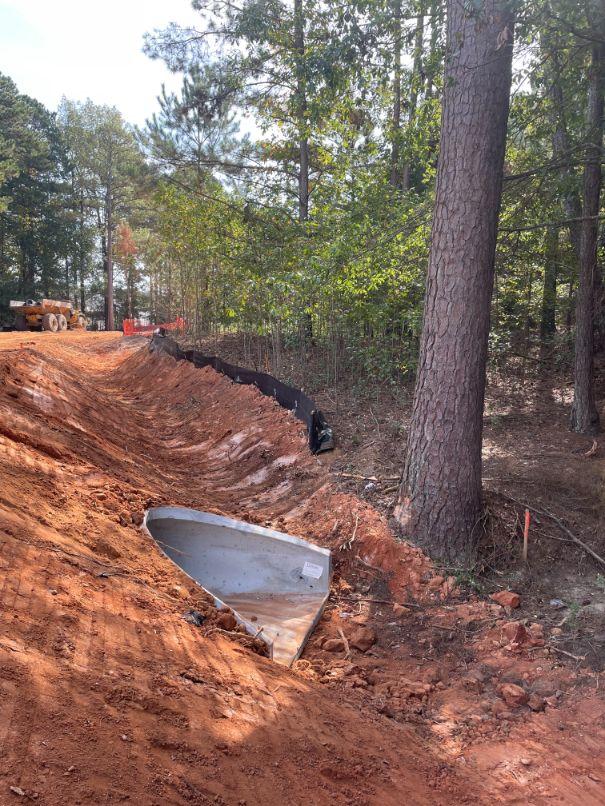

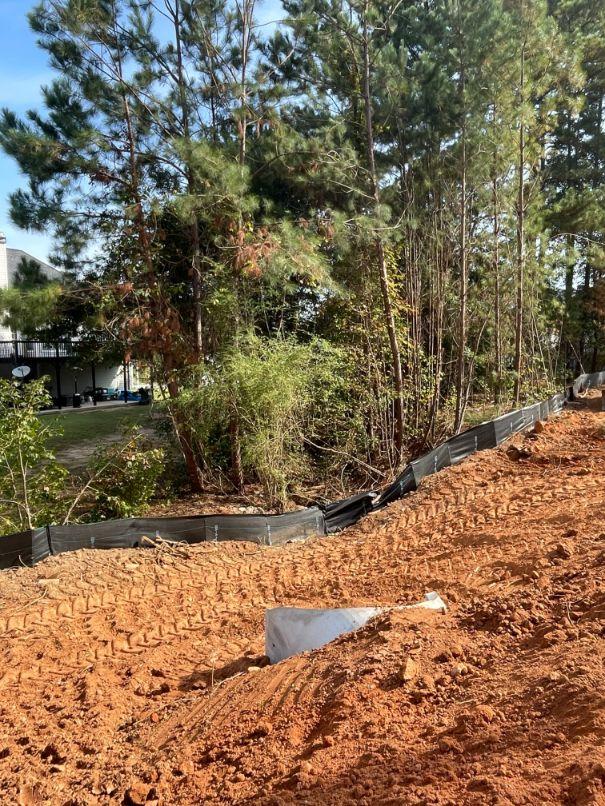

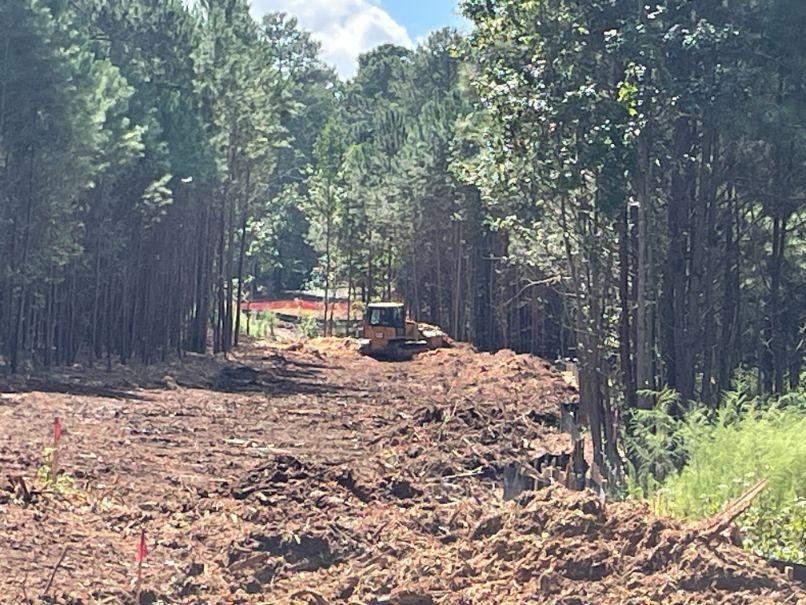

August 2023: Prime Engineering has begun clearing land for the trail. The 10-foot-wide walking path will be open to the Clayton County community once complete.
May 2023: This phase of project is pending finalization of the contract with Diversified Construction
Budget
$5 million
Commission District
District 2
Served by Commissioner
Commissioner Felicia Franklin
